Successful video editing projects give every task a clear owner, measurable deliverable, realistic deadline, and visible status. Centralizing these details with current media, feedback, and approvals keeps work moving efficiently.
Does your "almost finished" video keep stalling because nobody knows who should handle the captions, client notes, or final export? A well-structured task system makes ownership visible, identifies blocked work earlier, and prevents editors from acting on outdated feedback. The following workflow helps teams assign, monitor, review, and complete video production tasks without limiting creative freedom.
Why Video Editing Task Management Is Different
Editing is rarely one continuous task called "make the video." It is a chain of creative, technical, and administrative decisions involving footage preparation, story assembly, graphics, audio, color, captions, quality control, approval, and delivery.
A video task is a specific piece of work that produces a verifiable result. "Work on the edit" is not useful because nobody can objectively confirm what completion means. "Deliver a 90-second rough cut using the approved script and interview selects" is assignable and trackable.
Video work also creates dependencies. The colorist may need picture lock before grading. The sound editor may need a stable timeline before completing the final mix. The social media manager cannot schedule a vertical cut until it has captions and approval.
A practical production process typically connects pre-production, production and ingest, post-production, review and approval, and distribution and archiving. Your task system should reflect this entire journey rather than beginning when footage reaches the editor.
Build the Project Around Deliverables
Before assigning tasks, define what the project must produce. A single campaign might require a two-minute website video, a 30-second advertisement, three vertical social clips, a caption file, a thumbnail, and an archived master.
Each deliverable should have a purpose, audience, format, deadline, and approval owner. If those details remain vague, the project can appear busy while moving in the wrong direction.
For example, imagine a product launch scheduled for Friday. The main video must be approved by Wednesday so the marketing team has Thursday for uploading, metadata, scheduling, and final platform checks. Friday is not the editor's deadline; Wednesday is the approval deadline. That means the final internal cut might be due Monday and the rough cut the previous Thursday.
This backward-planning approach turns a distant launch date into meaningful production milestones. It also exposes unrealistic schedules before editing begins.
Divide Editing Into Trackable Stages

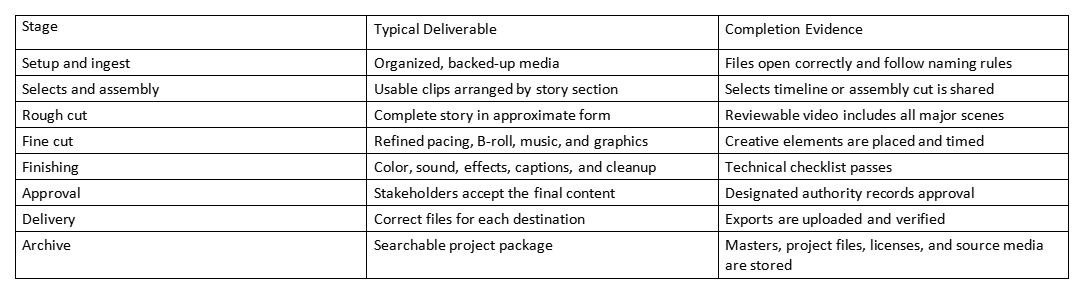

A reliable project board should mirror the way an edit develops. The exact process can vary by team, but its stages should be simple enough for everyone to understand.
Common editing stages similarly progress from setup and ingest through the rough cut, fine cut, finishing, approval, and delivery. Recognizable stages help collaborators understand whether they should be discussing story structure, visual polish, or technical corrections.
A rough cut, for example, should be judged primarily on story and structure. If stakeholders debate minor color differences during that review, the team may polish scenes that are later removed. Matching review criteria to the current stage protects both time and creative energy.
Write Tasks That Editors Can Finish
A strong task communicates the action, output, owner, deadline, source material, and definition of done. It should answer the editor's practical questions without forcing anyone to search through email threads.
Instead of writing "Add social versions," use a task such as: "Create approved 9:16 versions for vertical social channels using the final 16:9 master. Keep each version under 45 seconds, add burned-in captions, preserve the product reveal, and upload review files by 3:00 PM on Tuesday."
This wording establishes the format, duration, creative priority, caption requirement, delivery location, and deadline. The editor still makes creative decisions, but the operational expectations are no longer ambiguous.
The simplest viable process is usually the most effective because unnecessary steps create more opportunities for errors and overlooked work. Do not turn every mouse click into a separate task. Create tasks at meaningful handoff points where ownership, timing, or approval changes.
For a small social video, "Create fine cut" may reasonably include B-roll, music, basic graphics, and pacing refinements. For a national campaign with specialist contributors, those elements may need separate tasks because different people own editing, music clearance, motion graphics, and legal review.
Assign One Accountable Owner
Every task should have one directly accountable owner, even when several people contribute. Shared ownership often becomes invisible ownership because everyone assumes someone else is handling the work.
The accountable owner does not have to perform every action personally. A lead editor may own the finished fine cut while coordinating with an assistant editor and motion designer. The important point is that one person is responsible for moving the task forward, raising blockers, and delivering the expected result.
Assign work according to skill, availability, access, and workload. A fast editor is not automatically the right owner if that person is already handling two urgent cuts, waiting for large media transfers, or unable to access licensed assets.
Effective production coordination covers people, assets, schedules, supplies, and deadlines rather than treating editing as an isolated activity. This coordination matters when seemingly simple post-production tasks depend on music licensing, product footage, executive availability, or graphics from a designer.
Consider a five-hour graphics task. If the motion designer has only two available hours before the review deadline, assigning the task to that person does not make the schedule realistic. The project manager must reduce the scope, move the deadline, or provide additional support.
Connect Tasks With Dependencies
A dependency is a relationship in which one task cannot begin or finish until another reaches a required state. Mapping dependencies prevents downstream specialists from being blamed for delays that began earlier.
For example, "Final audio mix" may depend on "Picture lock approved," which may depend on "Legal feedback resolved." If legal feedback arrives two days late, the system should show the effect on audio, quality control, and delivery.
The timeline should also include milestones. A milestone marks an important decision or production state rather than a block of work. Common examples include script approval, production wrap, rough-cut review, picture lock, final approval, and campaign launch.
Kanban boards are effective for viewing current status, while timeline or Gantt views are better for understanding dependencies. Video teams often benefit from both: the board answers "What is happening now?" and the timeline answers "What will this delay affect?"
Use Statuses That Describe Reality

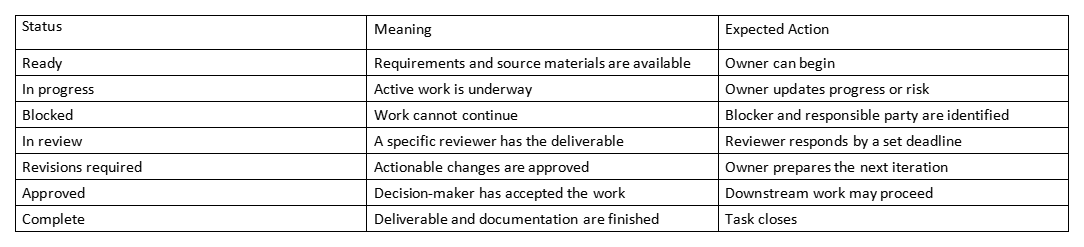

A task status should trigger a useful decision. Too many statuses create administrative work, while too few hide problems.
"In review" should never mean that someone dropped a link into a group chat. The status should identify who is reviewing, what kind of feedback is needed, and when the response is due.
Similarly, "blocked" must explain the obstacle. "Blocked: waiting for marketing" is weak. "Blocked: marketing must approve the product claim at 00:18 before picture lock; response needed by 12:00 PM Thursday" is actionable.
Centralize Media, Iterations, and Feedback
Task tracking fails when the board says one thing but the files and feedback live elsewhere. Each task should link directly to the current source material, review cut, brief, script, and relevant creative assets.
A consistent filename can include the project name, cut type, iteration number, and date. A file such as SummerLaunch_Rough_V03_20260713.mp4 communicates more than final_new_latest2.mp4.
Formal file tracking reduces the risk of editors working from outdated clips or reviewers commenting on superseded cuts. Older files should remain accessible for reference, but the current active cut must be unmistakable.
Feedback should also refer to exact video moments whenever possible. "The middle feels slow" forces the editor to interpret both the location and the reviewer's intent. "At 00:34-00:41, shorten the screen-recording section and reach the customer result sooner" gives the editor a clear problem to solve.
Designate one feedback owner to consolidate stakeholder comments. If five reviewers independently submit conflicting notes, the editor should not have to negotiate company strategy from the timeline. The feedback owner should resolve contradictions before revision work begins.
Control Reviews and Approval Rounds
Review is a task with an owner and deadline, not an informal pause between editing sessions. Name the reviewers before work starts and identify one person with final approval authority.
The first review should focus on whether the story works. Later reviews can address creative consistency, graphics, captions, sound, and technical delivery. Asking every stakeholder to review everything at every stage slows the project and encourages late creative changes.
Frame-accurate comments are especially valuable because they connect feedback to the relevant moment. A centralized review and approval process should also track changes and preserve a clear record of decisions.
Set an expected number of revision rounds in the project scope. Two planned rounds might include one structural review and one final refinement review. Additional rounds may require a timeline or budget adjustment, particularly when they introduce new creative direction rather than correct execution.
Late changes are expensive because they can reopen completed work. Replacing a scene after picture lock may affect the edit, color grade, sound mix, captions, graphics timing, and multiple exports. A five-second creative change can therefore create several hours of downstream work.
Track Time Without Micromanaging Creativity
Time tracking should improve estimates and expose bottlenecks, not monitor every moment of an editor's day. Record time against meaningful categories such as ingest, rough cut, motion graphics, revisions, exports, and project coordination.
Suppose a planned eight-hour edit takes 13 hours. The useful question is not simply why the editor was slower than expected. The task history may show two hours spent relinking poorly organized footage, one hour waiting for a missing logo, and two hours implementing feedback that arrived after approval.
That information helps the team improve future planning. The next estimate can account for media preparation, require creative assets during intake, and enforce the review deadline.
Compare estimated and actual time after each project. If social cutdowns repeatedly require four hours instead of the estimated two, update the template. Accurate estimates support healthier schedules and more reliable pricing.
Automate Repetitive Tracking Carefully
Automation is most valuable when it handles predictable administrative work. A task can automatically notify the reviewer when a cut enters review, send a reminder before the deadline, create platform-export tasks after approval, or generate an archive checklist after delivery.
AI can assist with transcripts, captions, metadata, technical checks, and clip discovery. However, creative priorities, story decisions, audience judgment, and final approval should remain under human control.
Automation should clarify responsibility rather than conceal it. If an automated task is created without a qualified owner, usable source files, or a realistic deadline, the process has only produced confusion faster.
Establish a Practical Weekly Rhythm
Begin the week by confirming milestones, priority deliverables, owner capacity, and outstanding dependencies. During production, owners should update tasks whenever the status changes, not only during meetings.
Short daily checks can focus on blocked work, reviews approaching their deadlines, and tasks that threaten the next milestone. Hold creative discussions separately when they require deeper attention; otherwise, a status meeting can expand into an unfocused editing session.
At the end of the project, compare planned and actual timelines, identify repeated causes of revisions, and update the project template. If captions were forgotten twice, add them to the finishing checklist. If approvals regularly take three days instead of one, adjust future schedules rather than continuing to plan around wishful thinking.
Avoid Common Assignment and Tracking Mistakes
The most damaging mistake is assigning vague tasks without completion criteria. Another is allowing several people to share ownership without naming the person accountable for delivery.
Teams also lose time when they track deadlines but ignore dependencies, collect feedback through multiple channels, begin editing before required assets are available, or mark a task complete before verifying its output.
Too many tools can create the same fragmentation that project software is meant to solve. Choose a system based on team size, production complexity, media integration, review needs, and client access. A simple board may be enough for a two-person team, while a high-volume studio may require workload planning, automated approvals, granular permissions, and deeper asset management.
Keep the Workflow Visible and Creative
Good task management does not turn video production into factory work. It removes uncertainty around ownership, files, feedback, and deadlines so editors can spend more energy shaping the story.
Define the deliverables, divide them into meaningful stages, assign one owner to every task, connect dependencies, and keep approvals with the current cut. When the workflow is clear, creativity moves faster-and "almost finished" finally becomes delivered.
